RTA awards contract for Improvement of Al Awir Road

RTA awards contract for Improvement of Al Awir Road, Entrance of International City Project (Phase II) costing AED193 million

0
1803
RTA awards contract for Improvement of Al Awir Road

The Board of Executive Directors of the Roads and Transport Authority (RTA), chaired by HE Mattar Al Tayer, Director-General and Chairman of the Board of Executive Directors of RTA, has awarded a contract for the Improvement of Al Awir Road, Entrance of the International City Project (Phase II). The Project costs about AED193 million.

“The Project is undertaken in collaboration with Nakheel, the master developer of the International City, in the light of the traffic impacts study commissioned for the International City and the Dragon Mart, especially after the opening of the extension of the Dragon Mart and the anticipated snarls in the area.

Phase II of the project encompasses improvements of Al Manama Street and upgrading the efficiency of its intersections namely Al Manama Street-Nouakchott Street, Al Manama Street-Sheikh Mohammed bin Zayed Road, and Al Manama Street-414 Street (Main entrance of the International City),” stated Al Tayer.

Improvement of Intersections
“Construction works in upgrading Al Manama Street-Sheikh Mohammed bin Zayed Road intersection include widening the flyover passing over Sheikh Mohammed bin Zayed Road from three to four lanes in each direction; which increases the capacity of the bridge from 4500 vehicles per hour to 6000 vehicles per hour.

It also covers increasing the number of lanes of slipways extending from Ras Al Khor Road to Sharjah, and from the International City to Jebel Ali and Abu Dhabi, from one lane to two lanes. This increase will double the capacity of these lanes from 800 vehicles per hour to 1600 vehicles per hour,” explained Al Tayer.

“Works also include widening Al Manama Street in the area between Sheikh Mohammed bin Zayed Road and the entrance of the International City from three to six lanes in each direction. This improvement will increase the intake of the road by 1500 vehicles per hour per lane. Al Manama Street will also be widened in the sector from the entrance of the International City to the Academic City Street from two to five lanes in each direction. The widening will enhance the capacity of this street from 3000 vehicles to 7500 vehicles per hour.

“Phase II of the project includes upgrading the intersection of Al Manama Street with the entrance of the International City by converting it into a surface signalised junction enabling free movement in all directions. Works include constructing a flyover of three lanes in each direction to allow traffic to cross freely over Al Manama Street; which will increase the capacity by 4500 vehicles per hour.

The existing surface intersection of Al Manama-Nouakchott Streets will be upgraded. Instead of allowing traffic movement from Al Manama Street leftward in the direction of Al Awir Road only, it will be converted to a signalised junction enabling traffic movement in all directions. Works also include the construction of a two-lane flyover to enable free traffic movement from Nouakchott Street leftward in the direction of the International City Street. The project will increase the street capacity by 3000 vehicles per hour,” he further added.

Phase I

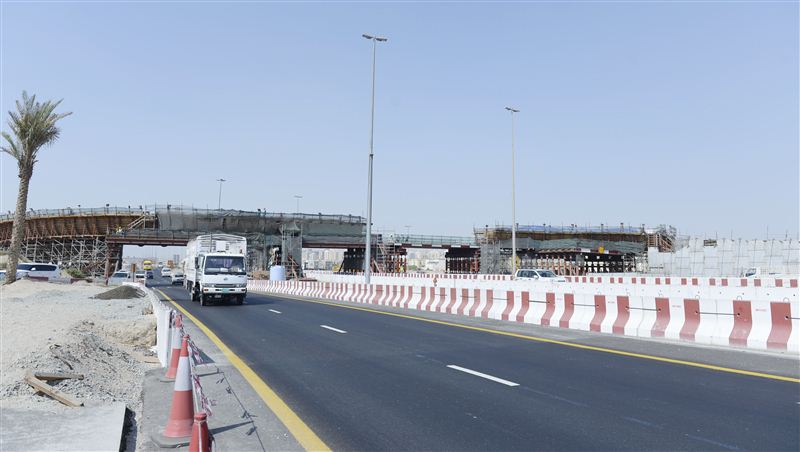

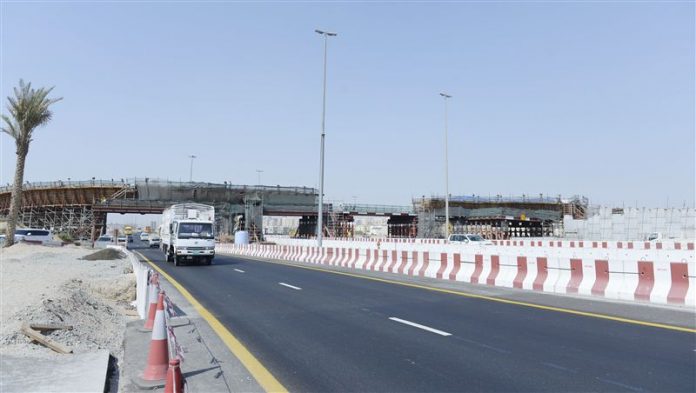

At the start of 2016, the RTA commenced construction works in Phase I of Al Awir Road and Entrance of the International City Improvement Project. Completion rate has so far reached 75% in the project, which is expected to be opened in the first quarter of 2018. Phase I of the project includes improvement works of Al Awir Road starting from the intersection of the Sheikh Mohammed bin Zayed Road to the R/A of the  Academic City.

Street. A free intersection comprising a two-lane flyover will be constructed between Al Awir Road and Nouakchott Street to ensure free movement of traffic coming from Nouakchott Street heading westward to Al Awir Road (in the direction of Dubai city centre). It also provides turns for the traffic running from Al Awir Road to the Sheikh Mohammed bin Zayed Road. The project also includes the construction of service roads in both directions of Al Awir Road to ensure a free traffic and separate it from the traffic of the International City, Dragon Mart and Al Warqaa.

Phase I of the project also encompasses the construction of a bridge for pedestrians and cyclists to ease the movement of pedestrians between Al Warqaa and the International City to the business district such as the Dragon Mart and the Vegetables Market. The primary four R/As inside the International City will be upgraded to signalised junctions, and the existing lane will be widened by adding one or two lanes in specific sectors. More info

Dubai Media Office
